|
|
Case Study: Implementing DDMRP in Eastern Europe
By Sviatoslav Oliinyk
The Eastern European/Central Asian market has a number of unique qualities.
Out here, the success of Western companies seems so distant from our
reality that it is simply not perceived as an argument in favour of
change. Western markets are more mature, according to this line of
thought, and therefore more stable, predictable, and easy to work in.
In addition, if you consider the financial capabilities that are
required to invest in personnel development, equipment, and enterprise
IT architecture, you run up against an established popular belief that
most of these solutions are not relevant to post-Soviet countries.
This article was written to debunk the aforementioned myth, since most
problems, as well as methods of their solution, are in fact universal
and common to all continents. In reality, the more complex and
unpredictable your business environment is, the greater benefit you
will get from using the Demand Driven approach. I will prove this to
you using the implementation of DDMRP methodology at Kormotech as an
example.
Introducing Kormotech
Kormotech
is a marketing and production company in the household pet care field.
Founded in 2003, the company owns three high-tech cat and dog food
factories in Europe and exports goods to 37 countries. In 2020,
Kormotech was fifth in the world in terms of growth rate and 61st in
terms of turnover, according to the top-100 household pet care companies ranking. It is a socially responsible company that seeks to change the culture of animal treatment in Eastern Europe.
Planning Before DDMRP
Before implementing DDMRP,
the company demonstrated stable annual growth of about 10%. The
company’s executives did not feel like there were any problems with
inventory management, but they wanted to increase automation levels
(i.e., avoid planning in spreadsheets), reduce stocks, and enhance the
system’s transparency. At that time, their inventory management system
was tuned to the traditional approach: first, the sales plan had to be
developed. After that, the production plan and the purchase of raw
materials would be approved based on that sales plan. Plans were
updated annually, monthly, and weekly.
The traditional approach to planning assumes that if each separate
function is effective, the system will be effective as a whole. For
example, if we have an accurate sales plan, an optimal production plan
and stock level, it will result in a high level of service and sales.
Unfortunately, this statement is only true for simple linear systems,
while most modern companies operate as complex and dynamic systems with
many different variables. Here’s an example of a contradiction within
such a system in the Kormotech company.
Production takes time. Typically, it involves the transportation and
preparation of raw materials, equipment calibration and setup,
production process, packaging, and preparation for shipment. In
addition, both the sales plan and the requirements for efficient use of
resources should be considered when performing all these operations. To
ensure enough time for stable and efficient production, a weekly plan
would be approved. By Friday, the company would already know what would
be produced next week, down to dates and quantities.
Besides, the entire process still needed to be monitored and managed. A
system of indicators was used for this purpose, including the widely
used “production plan fulfillment %” indicator. At first glance, it
seems that this one indicator can be used to assess two separate
aspects: the system’s reliability and manageability, on one hand, and,
on the other hand, its effectiveness, since the plan itself is built
with production specifics considered. The higher the % of plan
fulfillment is, the more predictably and efficiently production works.
But what if the market demand changes and goods are wanted in a
different quantity than planned? What is the planner supposed to do
then? Should he ignore the plan and be ineffective, or should he
produce the goods according to the plan and lose in service quality
(sales), but remain “efficient” in production?
Linear perception of the system within the traditional approach
suggests a simple management decision — shift the responsibility for
planning accuracy to the sales and marketing department. These
colleagues are supposed to know what and when we are going to sell, and
production just needs to operate efficiently as clockwork. Then the
whole system will be effective. But no matter how hard the sales
department tries, and what software they use, their sales forecast
resembles reality only at the aggregated level (month, quarter, product
family, etc.). While production planning and raw materials purchase are
required daily, at the level of SKU.
Mapping an Effective DDRMP Strategy
The
Demand Driven method enables companies to escape this vicious circle
and produce what the market really wants instead of what’s on the plan,
according to your production constraints. The ABM Cloud team, together
with the Kormotech team, decided to plan production daily, three days
in advance. Why three days? The head of the production planning
department determined this time frame to be sufficient for stable
production operation, enough to complete current operations, perform
preparatory work, produce the goods, as well as for subsequent work in
regular mode and even with a certain extra time margin included. Why
daily? Because the company’s customers place new orders every day!
At first, the idea seemed revolutionary and raised concerns that
production would not be able to plan three days in advance. What if the
orders suddenly peak and we simply don’t have enough time to produce
the required quantity? Or vice versa. What if there is a temporary
drawdown in customer orders for several days in a row? Should we just
stay idle then?
The DDMRP approach teaches us that the stock, time, and power buffers are interchangeable. When we defined the buffer profiles,
we considered the volume of production capacity required to compensate
for demand fluctuations. On one hand, this gives us the desired
stability, since the stock buffer compensates for the variability of
customer orders, and production replenishes buffers according to simple
and understandable priorities. And on the other hand, it brings
flexibility, since production planning is based on actual customer
orders (net flow balance equation), and we can be sure that we are
producing what the market wants, and not what we thought we could sell.
But before we could start managing the supply chain using the DDMRP
method, we had to do some preparatory work. Since previously all
management work had been done via Excel, many of the parameters
necessary for the automatic order generation were absent from the
accounting system and we had to create the forms for maintaining data
in ERP, as well as processes for entering and keeping data up to date.
We have made interesting discoveries while building the new processes,
and preparing for launch, some of which I will share below:
Takeaways From a DDMRP Transformation
1. Trying to minimize stocks leads to their increase
Sounds
like a paradox, doesn’t it? But what is the purchasing department’s
main task? To supply the production with raw materials. In practice,
this often means buying what’s listed in the monthly plan (considering
current surplus, goods in transit, reserves in production, and safety
stock) to meet production needs. The “A” and “B” products, which
require very expensive raw materials “Х”, are not present in the next
month’s production plan. Therefore, there is no point in purchasing and
storing “Х” in your warehouse. If we buy it, we will worsen the
turnover rate of our raw materials warehouse. Given the short delivery
time of “Х” (9 days), we can purchase it as soon as we need it. We just
need to wait for the product’s “A” and/or “B” to appear in the
production plan.
Using DDMRP algorithms, the system has calculated buffers for the
entire stored nomenclature and visualized the outcomes of such a policy
from a different angle. The fact that we do not store raw materials
does not mean that our customers will have to wait while we go through
the purchasing and production process before we ship finished products
to them. In other words, the company still stores stock, but in

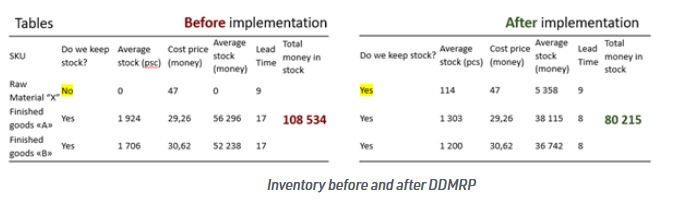

finished goods. You can see this in the table below.

We
suggested keeping a permanent stock of expensive raw materials “Х”. But
since only a small amount of it is needed for producing finished goods,
115 kg in the warehouse can fully meet the production demand. Having
placed a stock of raw materials “Х”, we have frozen money in raw
materials. But we’ve also reduced the Lead Time of Finished goods by 9
days, which means that the stock of Finished goods can be reduced. As a
result, the company has reduced the Lead Time, increased production
speed and reliability while decreasing stock by 26% at the same time.
2. Trying to minimize the purchase cost leads to its increase
Why
does it happen? People tend to take the path of least resistance. If
you need to reduce the cost of purchase, what is the fastest and
easiest way to do it? The answer is obvious to everyone who has worked
in procurement — purchase a larger batch. The more you buy, the lower
the cost per unit/kilogram of raw materials. The temptation is
especially great in the categories of packaging and labels. When
purchasing in huge quantities, the unit price drops to 60%!
By purchasing more, you will greatly improve your cost per unit index,
but it will also increase your total inventory cost. It is difficult to
resist buying 100 thousand packaging items instead of the required 6
thousand, even though it will take the company 2 years to use these 100
thousand units in production… But due to constantly fluctuating sales,
a 2-year stock could turn into a 3- or even 5-year stock in a few
months if sales rates do not meet our current expectations.
After a few months, the company may go through re-branding, or redesign
the packaging, or government requirements for packaging and labeling
may change, etc. And then the rest of our profitably purchased stock
will suddenly turn illiquid. This means that the cost of illiquid and
low-turnover inventories, as well as the costs of their storage and
future disposal, will also fall on the company’s shoulders, freezing
working capital and weakening the company’s financial performance in
the long term. For example, we found some dust-covered packaging tape
in the warehouse. When we asked why it was there, we received a simple
answer: “Someone bought it before my time.” And that employee had been
working in the company for several years…
I think that the key reason why people buy large quantities cheap lies
in a psychological divide between benefits and consequences. We tend to
consider the benefit at the time of purchase. For example, if you buy
100 thousand units and save 60 cents per unit, that means you have just
saved the company $60,000! While any consequences are likely to emerge
later, sometimes in years. And sometimes, given the average staff
turnover rate, it might not even be for you to clean up…

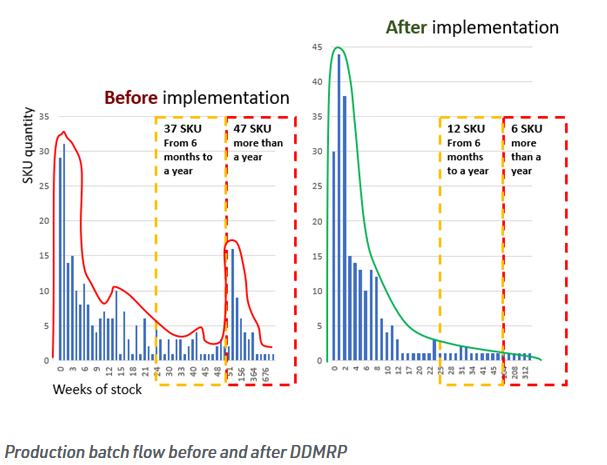

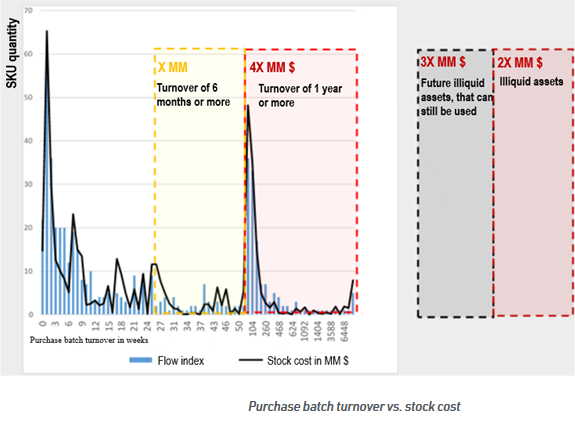

See the “Purchase batch turnover” chart for visualization of this issue.

The vertical axis represents SKU quantity, the horizontal axis represents the minimum purchase batch turnover measured in weeks.
The graph shows that X million (yellow dotted line) is the turnover of
the purchase batch from 6 to 12 months. 4X is the turnover of a year or
more. Regardless of the inventory management method, the very fact of
the purchase freezes the company’s money for years or more. This SKU
category is a candidate for “future illiquid assets”. 3X million –
“future illiquid assets”, are the SKUs that have no use in production,
but still have a very small chance to be useful at some point in the
future. And the final SKU category – 2Х million, these are illiquid
assets. The remainder of the purchase batches that cannot and will not
be used in production anymore. Additional costs are required for their
disposal.
There is a black line on the chart — the stock cost. Its purpose is to
visualize the relationship between the current cost of stock in the raw
materials and packaging warehouse, and the minimum purchase batch
turnover. The outlines of the black line follow the blue columns. In
other words, batches with poor turnover are not only problematic as per
relative indicators, but also make up a large part of the stock in
monetary terms.
Less than 40% of the unique raw material SKUs were ordered during the first quarter of DDMRP method usage.
After seeing this chart, the company has revised its purchasing
department target figures by limiting the sizes of purchase batches
from the right side of the chart.
That is the purpose of this chart. There’s no need to revise all the
purchase batches. Start at the right side of the distribution and look
at the items with the lowest turnover.
3. Trying to optimize production batches leads to their imbalance
Those
of you who have performed batch optimization will confirm that after
calculating an optimal batch, there is usually a general trend towards
an increase in production batches. In most cases, it is readily
accepted and even encouraged by production managers. I will not get
into formulas for calculating the optimal batch, there are many sources
on the Internet explaining different ways to achieve large production
batches. I want to talk about the motivation of managers in production.
I like Carol Ptak’s saying: “Tell me how you measure me, and I will
tell you how I will behave.”
If you are measuring production efficiency, percentage of waste, and
percentage of downtime, then there are very specific ways to influence
these indicators. Usually, each launch of a specific SKU production
involves a certain fixed share of losses, 100 kg for example. That’s
what remains on the walls of equipment, pipes, blades, etc. Therefore,
if you have produced 1000 kg of a finished product, you have 100 kg of
ingredient losses, which is 10%. If you’ve produced 5000 kg of product,
you will still lose 100 kg of raw material, or 2%. Note that we have
just reduced production waste by 5 times! But at what cost …
Kormotech had calculated the optimal production batch, which minimized
the company’s raw material losses on one hand, and on the other hand,
maximized the equipment performance efficiency. A one-time production
of 3000 kg for one SKU was considered optimal. The problem was that the
3-ton batch was indeed “optimal” for production, but not for the
company. The sales of each item are different, but the production batch
is fixed. This means that some batches will be put into production
regularly, while other ones – very rarely. See the “Flow Index” chart
for visualization of the “optimal” production batch turnover.

The
vertical axis represents SKU quantity, the horizontal axis represents
the optimal production batch turnover measured in weeks.
Let’s focus on the right side of the “Before implementation” chart,
which shows that 37 SKUs have a batch turnover of 6 months to a year,
and 47 SKUs have a batch turnover of over a year. What does this mean
for production? That they have produced the batch in one go, the
percentage of losses is minimal, and let the warehouse department
figure out what to do with this huge stock.
In addition to a shortage of space in the finished goods warehouse,
this “optimal” production batch also led to a large-scale process of
write-offs and product returns from customers. This chart raised a
simple question: what’s the point of efficiently producing 3 tons of
products if 1 or even 2 tons of it will end up written off. It means
waste of expensive raw materials, warehouse space, operations, as well
as the time of production team and equipment wear.
It became obvious that simply changing the planning procedure was not
enough to solve the problem. It was necessary to completely re-evaluate
the policy of optimal batches. Here is what we did:
1. We started grouping items with common semi-finished ingredients
together for production purposes, since production of these ingredients
was what created limitations for the system. After that, the product
was packed in different sizes, which resulted in 1-3 SKUs of the
finished product.
2. Instead of “optimal” batches, we started using minimal batches. The
technological process was what determined their size (0.5 tons).
You can see the results of these two steps on the right side of the
“After implementation” chart. Note that the number of problematic SKUs
has been reduced by 4.5 times. We have freed up storage space,
increased inventory turnover, and minimized returns and write-offs.
But this approach has its downside. The number of changeovers will
definitely increase! If previously producing 3 tons in one go was
enough for 6 months, now the product will be put in production every
month, which means 5 additional changeovers in six months. If the
changeover takes 1 hour, then we have increased the plant downtime by 5
hours per 6 months. And what if there’s a lot of products like that?
This will both worsen the production efficiency indicators, and reduce
the total volume of produced goods, which is simply unacceptable
considering the constant growth of the company’s sales!
Since we sped up the slowest SKUs (by reducing their production
batches), we now need to slow down the fastest ones. They can be found
on the left sides of both charts, but as you can see, the “After
implementation” chart has a lot more of them. To prevent this, we
consider the order cycle indicator when calculating the green zone of
the buffer.
3. The desired production cycle was determined to be once per every 7
days, based on the results of the production load simulation. This
allowed us to compensate for the time lost in changeovers due to the
reduction in slow-selling SKU batches and to improve production
indicators, stabilize the production process, and, most importantly,
increase the total volume of produced goods.
DDMRP Implementation Results

What
are the results of a transition to DDMRP? As a result of Kormotech’s
methodological and planning processes automation (which served as a
foundation ensuring the sustainability of the supply chain management
transformation), the following results were achieved between April and
September of 2017:
1. Finished goods:
Automated the planning process
Increased Service Level from 90 to 99%
Reduced overall stock level by 45% while increasing production volumes by 40%
2. Raw materials and packaging:
Automated the planning process
Reduced surplus by 50%
The overall stock level remained the same, while production increased by 40%
3. Flow:
Reduced the amplitude of fluctuations in weekly production volumes by 2.5 times
How DDMRP Impacted the Company’s Workflow
1. It reduced warehouse requirements
At
the start of the project, we received a request to help justify the
necessity of expanding the warehouse space. At one point before the
project launch, the company was forced to temporarily stop the
warehouse operation and prematurely ship a portion of the stock to
distributors, since it was physically impossible to accept new items
from production. By the end of the project, the need to rent additional
storage space disappeared. Moreover, a lot of extra space was freed up
in their warehouse. That was the impact of revising optimal batches and
avoiding production plans, which became outdated faster than they could
be fulfilled, with inherent errors in long-term forecasts, which were
offset by the safety stocks increase.
2. It provided a single universal dashboard
Previously,
there was a constant need to change the details of an already approved
plan due to non-standard customer orders, or due to their absence. As a
result, whatever had been planned earlier was better off not being
produced at all. The production department was caught between a rock
and a hard place. Produce what they ask, and it will worsen the
performance indicators. Fail to produce it, and the company will lose
money. “It’s hard to imagine that kind of situation today,” says the
production manager. The person who plans the production sees the real
market demand before anyone else, since all customer orders are visible
in the planning window and that is what determines the production
priority and volumes. Since everyone has the same visibility and
understanding of the situation, all those letters and calls from the
distribution are a thing of the past. The same goes for the raw
materials and packaging stocks management. The purchasing department
manager can see the real demand and any possible risks of shortage
before it happens. If you can see a problem in advance, you’ll have a
high chance to solve it in time.
3. It stabilized enterprise operations in the face of unstable demand
Thanks
to moving away from weekly plans, the fluctuations in production

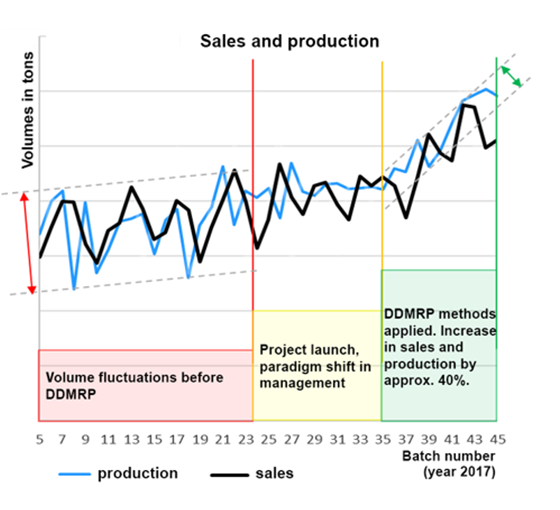

volumes have also disappeared (see the “Sales and production” chart).
Previously, if the weekly plan was fulfilled a little earlier, that
meant we could relax at the end of the week. This can be observed in
the chart at the points where the blue line (production volumes) is
dropping. If this week’s production volume was smaller, then next week
we would likely have to produce a lot more (but we wouldn’t know that
until we got the new plan on Friday). Imagine having to plan the
production process, the raw materials supply, the employee schedules,
etc. in these conditions. How effective could you possibly be? As
Edwards Deming used to say, if you want to improve the system’s
efficiency, reduce variation. According to Deming, there are two types
of variation: common cause and special cause. Common cause variation
can usually be neglected, but by using traditional planning, the
company exposes itself to special cause variation as well. Now look at
the second part of the chart, representing the switch to DDMRP. The
weekly fluctuation in output volumes decreased by 2.5 times. Imagine
how much your planning and resource use efficiency would increase if
you produce approximately the same volume of products every week.
4. It helped optimize the operational environment
Optimizing
the operational environment is much easier and much more effective once
the production process is stable. DDMRP also helps to digitize the
effects. If, for example, you have reduced the changeover time, then
you can also shorten the average order cycle, while at the same time
reducing the overall stock level. DDMRP logic-based software allows you
to simulate this in a few clicks and evaluate the economic effect, as
well as to adapt planning and production to new conditions quickly and
easily.
This project was very challenging and insightful both for the company’s management and implementation team.
It provided a great expertise, revealed weak sides of previous planning
approach, opened new opportunities for the company’s development and
most importantly, brought impressive effects in inventory management.
Get in Touch
For more information, contact Colin Seftel.
Sviatoslav Oliinyk Co-founder
of Representative office of Demand Driven Institute in CIS region,
business trainer and supply chain management consultant at ABM Cloud.
Experienced in business process re-engineering, project management
using Lean, 6 Sigma and TOC in retail, distribution and production.
Certified expert in Innovative Solutions for Supply Chain optimization,
specialized in DDMRP methodology education and implementation. Author
of various case studies and business media publications, event speaker,
founder and coordinator of business training clubs, practicing expert
in corporate culture development, coaching, team building.
|
